Joints and Crack Control

Reviewed August 23, 2026

In learning paths: Concrete Work to ACI Certification

Assumes you know: Finishing Flatwork

Concrete shrinks as it dries, and restrained shrinkage means cracks: not a risk, a certainty. Jointing is how you negotiate with that certainty. A control joint does not prevent the crack; it invites it to happen along a straight, clean line you chose, instead of wandering across the middle of the slab.

Why it matters on the job

A random crack and a controlled crack are the same physics with opposite outcomes: one is a defect the owner photographs, the other is a joint nobody notices. Joint layout, depth and timing are cheap decisions made once; random cracking is permanent. Foremen and finishers own these decisions on most flatwork.

The joint taxonomy

Four names, four different things, and mixing them up causes real detailing errors:

  • Control (contraction) joint: a deliberately weakened plane, sawcut or tooled into the slab, that tells the shrinkage crack where to run. The crack forms below the cut, hidden and straight.
  • Construction joint: where a pour stopped and a later pour continued. Planned, formed, often keyed or doweled to transfer load. A good construction joint is placed where a control joint was wanted anyway.
  • Isolation (expansion) joint: a full-depth, full-width separation (compressible filler) between the slab and anything fixed: columns, walls, footings, drains. It lets the slab move without pushing against the structure. Nothing crosses it, including reinforcement.
  • Cold joint: the accident. Fresh concrete placed against concrete that already stiffened, with no plan and no preparation. It is a defect to prevent, not a joint type to specify.

The two numbers that control cracking

Depth: one quarter of the thickness. A sawcut or tooled groove must reach D/4 to reliably weaken the plane; shallower cuts get ignored by the crack.

Spacing: 2 to 3 times the thickness, read in feet. Take the slab thickness in inches, multiply by 2 to 3, and treat the result as feet (a 4 in slab wants joints every 8 to 12 ft). Keep panels close to square, and never let a panel’s long side run past about 1.5 times its short side. Cut extra joints at re-entrant corners (inside corners at boxouts and openings), because cracks launch from them.

Timing: as soon as the saw will not ravel the cut. Shrinkage stress builds from the first hours; a cut made the next morning often finds the crack already there. Conventional saws enter within roughly 4 to 12 hours of finishing (sooner in hot weather); early-entry saws cut within the first few hours. Cutting concrete is also a silica task: wet-cut or use a shrouded saw with dust collection per Table 1, never a dry blade in open air.

Worked example: jointing the patio slab

The same 30 ft by 20 ft, 4 in slab from the placing lesson:

  1. Spacing: 4 in × 2.5 = 10, so joints every 10 ft.
  2. Layout: 30 / 10 = 3 panels one way, 20 / 10 = 2 panels the other: six 10 ft by 10 ft squares, cut at two lines across the length and one across the width.
  3. Depth: 4 / 4 = 1 in cuts.
  4. Aspect check: 10 / 10 = 1.0, comfortably under 1.5.

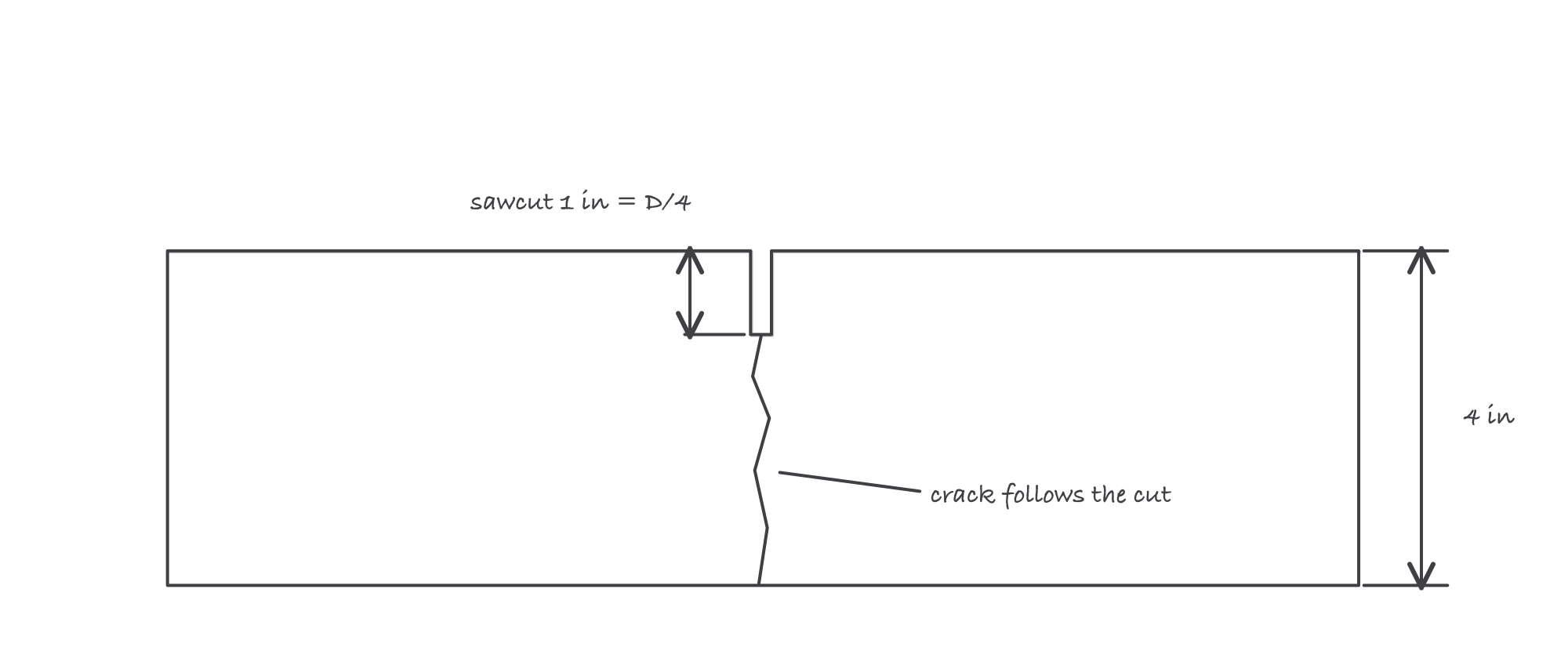

Cross-section of a 4 inch slab with a 1 inch sawcut at the top and the shrinkage crack running from the bottom of the cut to the bottom of the slab

The cut is the invitation: a D/4 groove weakens the plane and the shrinkage crack accepts, straight down and out of sight

Where it bites

  • Shallow cuts. A 1/2 in scratch in a 5 in slab controls nothing; the crack goes where it pleases. D/4, measured, every joint.
  • Cutting on tomorrow’s schedule. Joint timing belongs to the concrete and the weather. If the crew leaves before cutting, the crack often beats the saw to it.
  • Re-entrant corners without relief. Every inside corner is a crack starter; give each one a joint or diagonal reinforcement.
  • Isolation joints doing control duty (or the reverse). A control joint is a weakened plane in continuous concrete; an isolation joint is a full separation. Swap them and you either crack at the column or lose load transfer where you needed it.
